The Scalability Inversion Trap: Why the Corporate Gift Box Type That Performed at 200 Units Becomes Operationally Unviable at 2,000
When the production floor receives a reorder at five times the original volume, the box type that looked like the right decision at pilot scale reveals structural constraints that no amount of budget increase can resolve.
There is a specific moment in a corporate gift programme's lifecycle where the original box type decision stops working, and it almost never coincides with the moment the procurement team notices. The programme launches with 200 units—a pilot run for a Hari Raya client appreciation initiative, perhaps, or a Chinese New Year distribution to key accounts. The rigid paper-wrapped box with magnetic closure, custom EVA insert, and hot-stamped logo arrives on time, within budget, and the internal feedback is positive. The box feels premium. The unboxing sequence works. The marketing team photographs it for LinkedIn. The procurement file is closed with a note that reads something like "approved format for future orders."
Six months later, the same programme is extended to the company's full client base. The order volume moves from 200 to 1,800 units. The procurement team issues a repeat order to the same supplier, expecting proportional pricing—nine times the volume, roughly nine times the cost, possibly with a modest volume discount. What arrives instead is a revised quotation where the per-unit cost has barely decreased, the lead time has tripled, and the supplier has flagged warehousing constraints that did not exist at 200 units. The procurement team interprets this as a supplier problem. In practice, it is a box type problem. The format that was selected, approved, and locked in at pilot scale carries structural characteristics that resist the economies of scale the procurement team assumed would materialise.

The mechanics of this inversion are not intuitive, which is precisely why it catches experienced procurement teams off guard. A rigid paper-wrapped box is constructed from pre-cut greyboard panels that are individually wrapped with printed paper, then assembled by hand. At 200 units, the hand-assembly labour is a manageable line item—typically 8 to 12 minutes per box depending on complexity, with a team of four or five assemblers completing the run in two to three working days. At 1,800 units, that same hand-assembly process requires the same 8 to 12 minutes per unit because the operation cannot be meaningfully automated. The labour scales linearly. A team of five assemblers now needs 18 to 25 working days for the box assembly alone, before any insert fitting, content placement, or quality inspection. The supplier either extends the lead time or hires temporary workers who have not built muscle memory for the specific wrapping tension and corner-fold technique that determines whether the finished box meets quality standards.
The storage dimension compounds the problem in ways that procurement teams rarely model at the quotation stage. Rigid boxes cannot be stored flat. They arrive from the assembly line as fully formed three-dimensional objects that occupy their full volume in warehouse space. At 200 units, this means approximately two to three standard pallets of finished boxes awaiting content insertion. At 1,800 units, the same box format requires 16 to 25 pallets of warehouse space for a product that has no contents yet. In the Malaysian context, where many gift box suppliers operate from facilities in Klang Valley industrial estates with limited climate-controlled storage, those 25 pallets are competing for space with other clients' production runs during the same seasonal window. The supplier's warehouse constraint becomes the programme's lead time constraint, and the procurement team has no visibility into this bottleneck because it was never a factor at 200 units.

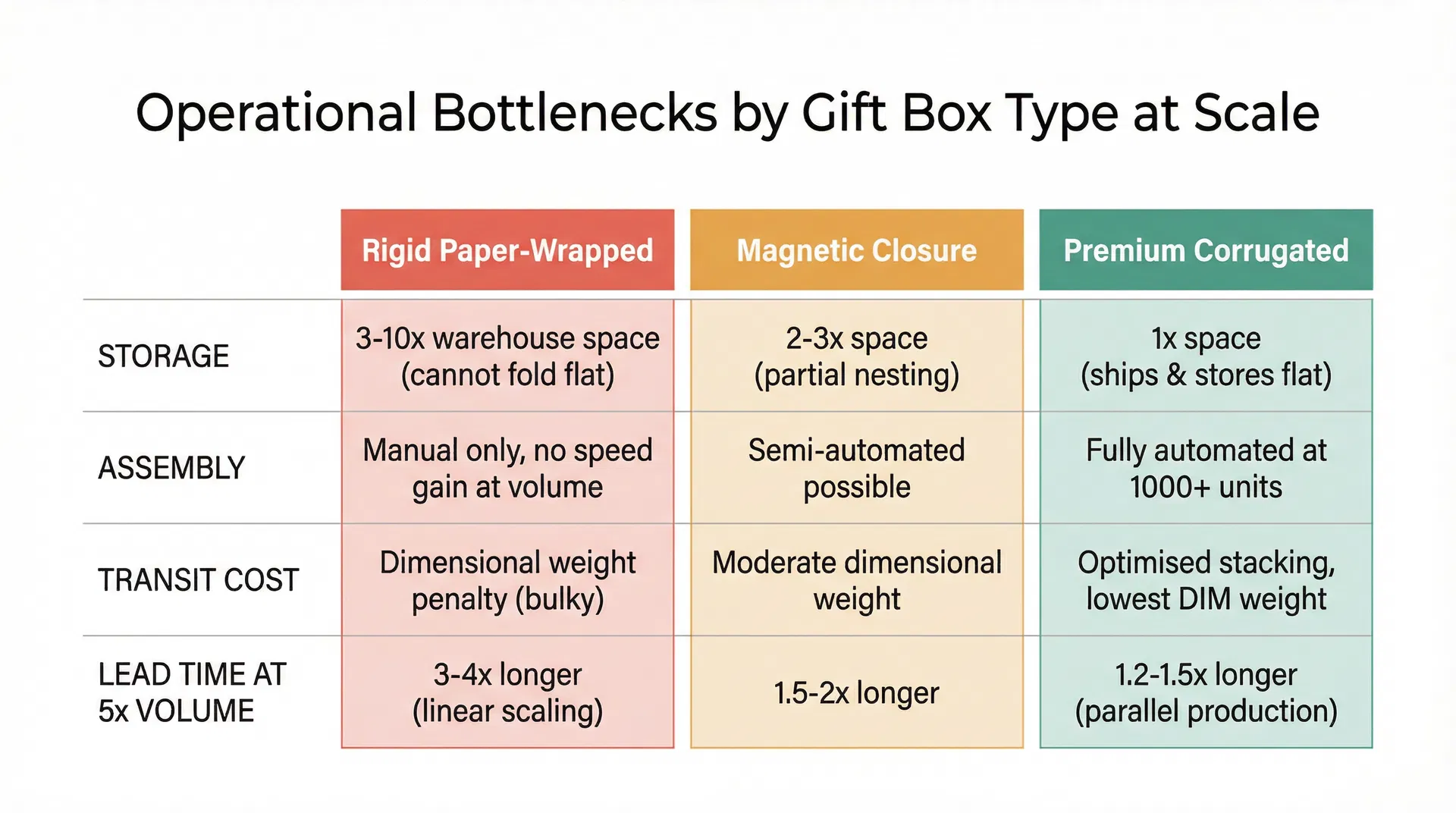

In practice, this is often where corporate gift box type decisions start to reveal their hidden assumptions. The pilot-scale evaluation assessed the box on its merits as a finished product—tactile quality, visual impact, unboxing experience, brand alignment. None of these criteria change with volume. What changes is every operational parameter that sits between the purchase order and the delivery: production throughput, assembly labour availability, warehouse footprint, transit packaging efficiency, and quality consistency across a larger run. The box type that scored highest on the product evaluation matrix may score lowest on the operational scalability matrix, and the two matrices are never presented side by side during the approval process.

The transit cost dimension introduces a further inversion that is specific to the Malaysian logistics environment. Courier and freight services in Malaysia price shipments using whichever is greater: actual weight or dimensional weight. Rigid boxes, by their non-collapsible nature, carry a dimensional weight penalty that is disproportionate to their actual weight. A rigid paper-wrapped gift box measuring 30cm × 25cm × 12cm with a magnetic closure weighs approximately 350 to 500 grams empty, but its dimensional weight calculation—length times width times height divided by 5,000 for domestic courier—yields a dimensional weight of 1.8 kilograms. At 200 units shipped individually to client offices across Kuala Lumpur and Selangor, the dimensional weight surcharge is absorbed into the per-unit shipping budget without triggering a review. At 1,800 units, the cumulative dimensional weight penalty across the programme can exceed RM 8,000 to RM 15,000 depending on delivery spread, and that figure was not in the original programme budget because it was extrapolated from the 200-unit pilot where shipping costs appeared proportional.

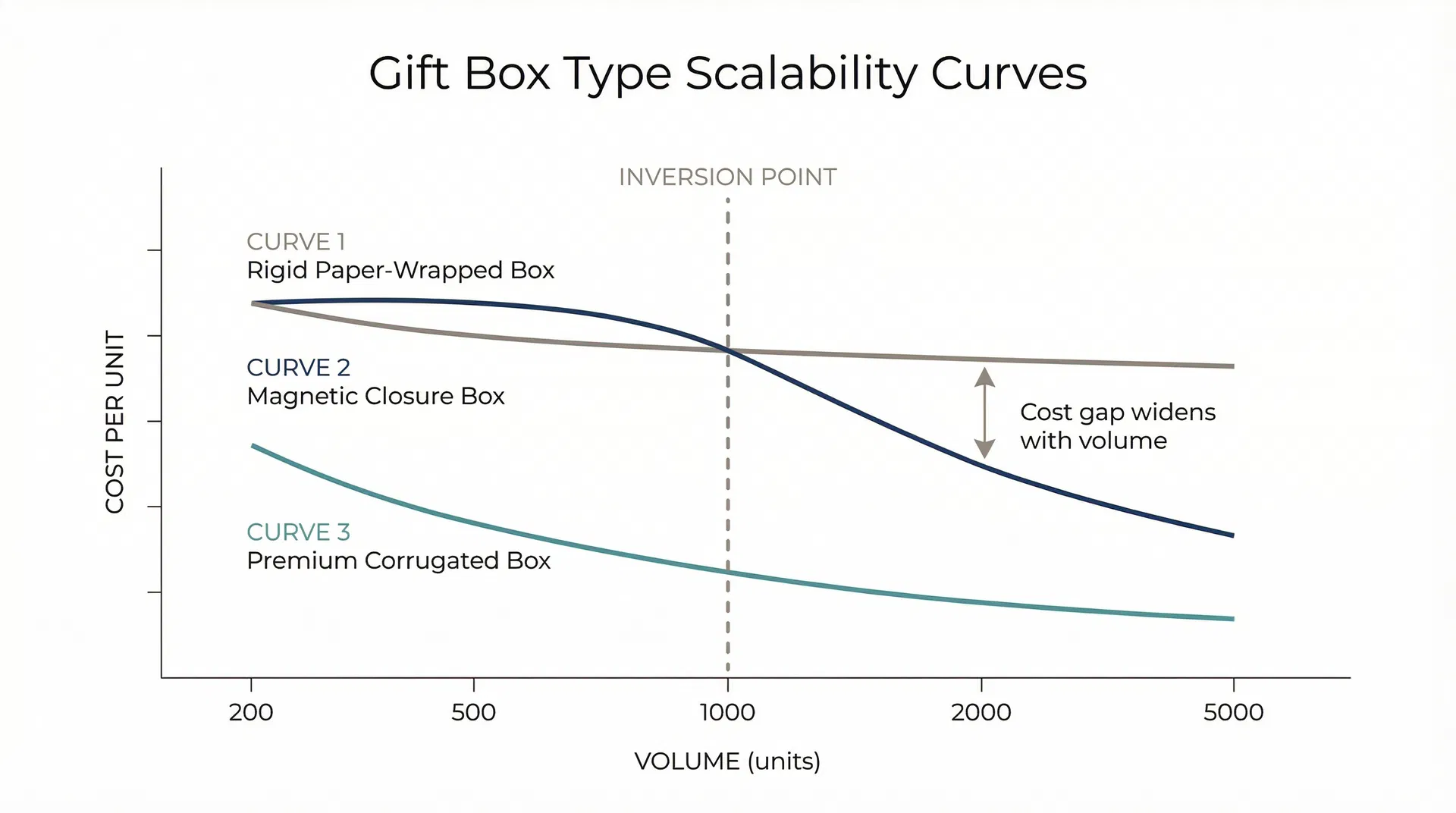

A magnetic closure box with a collapsible structure—where the box ships flat and is erected at the fulfilment stage—occupies roughly one-third the transit volume of an equivalent rigid box. A premium corrugated box with high-quality printing and lamination ships flat at approximately one-tenth the volume. The per-unit production cost of the corrugated option may be 30 to 40 percent lower than the rigid option, but the transit cost saving at 1,800 units can equal or exceed the production cost difference. The total programme cost inversion—where the "cheaper" box type becomes more expensive than the "premium" alternative at scale—typically occurs between 800 and 1,200 units for programmes with distributed delivery across multiple locations.
The lead time inversion follows a similar pattern but is harder to recover from because time, unlike cost, cannot be supplemented with additional budget. A rigid box production run scales roughly linearly with volume: double the units, roughly double the production time, because each unit requires the same sequence of manual operations. A corrugated box production run scales sub-linearly because the printing, die-cutting, and folding operations are machine-driven processes where setup time is fixed and throughput increases with volume. At 200 units, both box types might quote a 12 to 15 working day lead time. At 1,800 units, the rigid box lead time extends to 35 to 45 working days while the corrugated box lead time extends to 18 to 22 working days. For a programme tied to a fixed calendar event—Deepavali, Christmas, or a company anniversary—the lead time difference between box types at scale is the difference between comfortable execution and emergency air freight.
The question that procurement teams need to ask during the pilot evaluation—and almost never do—is not "does this box type meet our quality and brand standards?" but rather "does this box type meet our quality and brand standards at the volume we expect to reach within 12 months?" The distinction matters because selecting the right type of corporate gift box for a business need is not a static decision. It is a decision that must account for the programme's growth trajectory. A box type that is optimal at 200 units and suboptimal at 2,000 units is not a good pilot choice—it is a format that will need to be changed precisely when the programme has built internal expectations and stakeholder familiarity around the original format.
From the production floor, the scalability inversion is visible long before it reaches the procurement team's desk. When a reorder arrives at five times the original volume, the production planner's first calculation is not the material cost—it is the assembly labour hours, the warehouse pallet positions, and the production line days required to complete the run without displacing other committed orders. For box types with high manual-labour content, the answer to that calculation is almost always "this volume requires a format conversation, not just a pricing conversation." But that conversation rarely happens because the procurement brief specifies the format as fixed and asks only for updated pricing. The supplier provides the pricing, flags the extended lead time, and absorbs the operational complexity into their margin rather than recommending a format change that might appear to contradict the client's approved specification.
The practical implication for procurement teams managing multi-year or recurring corporate gifting programmes is that the pilot-stage box type evaluation should include a scalability stress test. Before locking in a format based on a 200-unit sample run, the team should request from the supplier a comparative quotation at three volume tiers: the pilot volume, the expected Year 1 volume, and the projected Year 2 volume. The quotation should include not just per-unit production cost but also per-unit storage allocation, per-unit assembly time, and per-unit dimensional weight for transit. When these four variables are plotted across the three volume tiers, the scalability curve for each box type becomes visible, and the inversion point—where the pilot-stage favourite becomes the scaled-stage liability—can be identified before it becomes a programme constraint. The teams that build this analysis into their evaluation process do not necessarily choose the cheapest box type. They choose the box type whose operational profile matches the programme's volume trajectory, and that choice almost always differs from the one that would have been made based on a 200-unit sample evaluation alone.
Related Articles
Corporate Gift Box Types for Business Needs
Decision framework for Malaysian enterprises: matching corporate gift box types to business objectives, budget constraints, and compliance requirements.
The Climate Durability Blind Spot
Why gift box types evaluated in air-conditioned showrooms fail differently under Malaysian warehouse and transit conditions.
