The Contents-First Sequencing Error: Why Locking the Corporate Gift Box Type Before Finalising Contents Creates Cascading Production Rework
When the box format is approved before the contents lineup is confirmed, every subsequent change to the gift items triggers a rework chain that the original timeline and budget did not account for.
On the production floor, we track a metric that never appears in any procurement report: the number of structural sample revisions per project. Across our corporate gift box programmes over the past eighteen months, projects where the box type was locked before the contents lineup was finalised averaged 2.4 structural revisions before production could begin. Projects where the contents were confirmed first averaged 0.3 revisions. That difference—two additional rounds of structural sampling—translates to roughly RM 2,500 to RM 5,000 in unplanned tooling costs and 10 to 18 working days of timeline extension per project. None of this appears in the original quotation because the original quotation was built on the assumption that the contents would fit the box. They rarely do, when the sequence is reversed.
The pattern is remarkably consistent. A procurement team receives internal approval for a corporate gifting programme. The budget is allocated. The brief goes out to suppliers with a box type already specified—typically a rigid magnetic closure box or a two-piece lid-and-base box, because these formats photograph well in the proposal deck and communicate premium positioning to the internal approvers. The supplier quotes based on the specified format. The production slot is tentatively reserved. Then, over the following three to six weeks, the contents lineup evolves. The marketing team adds a branded notebook that was not in the original brief. The HR team requests a different tea brand because the original supplier cannot meet the delivery date. The CEO's office asks to include a pen set that is 22mm taller than the placeholder item in the original specification. Each change, individually, seems minor. Collectively, they invalidate the internal dimensions of the box that was already approved.

The reason this sequencing error persists is structural, not cognitive. Procurement teams are not unaware that contents might change. They lock the box type early because the internal approval process demands it. A corporate gifting proposal that says "we will determine the packaging format after the contents are confirmed" does not pass budget review in most Malaysian corporations. The approvers want to see the box. They want to see the rendering. They want to know the per-unit cost before they sign off. The box type becomes the anchor of the proposal because it is the most visually communicable element of the programme, and visual communication is what moves proposals through approval committees. The contents—a collection of items that may still be in negotiation with multiple suppliers—cannot serve that anchor function because they are not yet fixed. So the box gets fixed first, and the contents are expected to conform to the box. On the factory floor, we call this "building the house before measuring the furniture," and it generates more mid-project change orders than any other single cause.
In practice, this is often where corporate gift box type decisions start to compound in ways that the procurement team does not anticipate. A rigid magnetic closure box has fixed internal dimensions once the structural sample is approved. The walls are 2.5mm to 3mm greyboard wrapped in art paper or specialty material. The magnetic closure mechanism requires a specific lid depth. The internal cavity is a precise rectangle with tolerances of plus or minus 1.5mm. When the contents change—and they almost always change—the cavity either has too much dead space (which makes the contents rattle and shifts during transit, damaging the unboxing experience) or too little clearance (which makes the items difficult to remove and risks compression damage to the contents). Neither outcome is acceptable for a programme that was specified as premium, but both outcomes are inevitable when the box dimensions were locked before the contents dimensions were known.

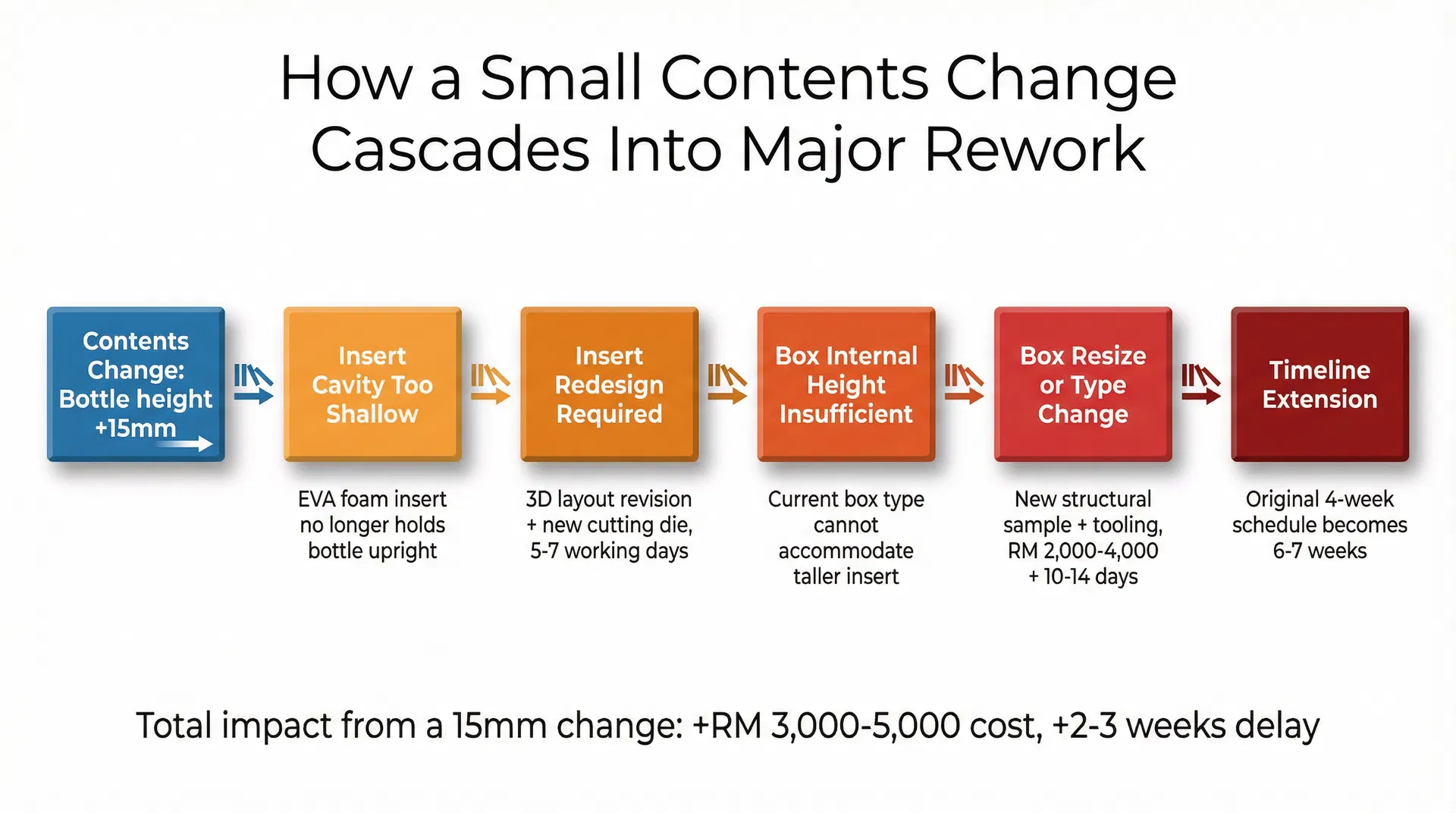

The insert is where the cascade becomes most expensive. A custom EVA foam insert or die-cut cardboard insert is engineered to hold specific items in specific positions. The insert design begins with a 3D layout that maps each item's footprint, height, and weight distribution. The cutting die is manufactured based on this layout. When a single item changes dimensions—even by 10 to 15mm in one axis—the insert cavity for that item no longer provides the correct fit. If the item is taller, the cavity is too shallow and the lid will not close flush. If the item is wider, adjacent cavities may need to be repositioned, which can trigger a complete insert redesign rather than a simple cavity adjustment. The cutting die, which costs RM 400 to RM 1,200 depending on complexity, becomes scrap. A new die must be manufactured, which adds 5 to 7 working days to the timeline. If the new insert layout requires more internal depth than the original box provides, the box itself must be resized—which means a new structural sample, new wrapping material dimensions, new printing plates if the exterior is printed, and new tooling for the box construction. A 15mm change in one item's height can cascade into RM 3,000 to RM 5,000 of additional cost and two to three weeks of additional lead time.

The box types that are most vulnerable to this sequencing error are precisely the ones that procurement teams select most often for premium programmes. Rigid magnetic closure boxes, drawer-style boxes, and two-piece lid-and-base boxes all have fixed structural geometries that cannot absorb dimensional changes without re-engineering. A rigid box cannot simply be "made a bit taller" the way a corrugated mailer can have its flaps extended. The greyboard must be re-cut, the wrapping material must be re-sized, the magnetic placement must be recalculated, and the entire assembly sequence must be re-validated. Ironically, the box types that are most forgiving of contents changes—corrugated mailers, tuck-end boxes, and sleeve-style packaging—are the ones that procurement teams dismiss early in the selection process because they do not present as premium in the proposal deck. The question of which box types serve different business needs becomes significantly more nuanced when the decision sequence is factored in, because a box type that is technically ideal for the programme may be operationally unsuitable if the contents timeline does not support early dimensional lock.
There is a specific version of this problem that we see in Malaysian corporate gifting programmes during Hari Raya and Chinese New Year seasons. The procurement team begins planning in August or September for a December or January delivery. The box type is approved in September based on a preliminary contents list. Between September and November, the contents undergo two or three rounds of revision as internal stakeholders weigh in, supplier availability shifts, and budget allocations are adjusted. By November, the final contents list bears only partial resemblance to the September version. The box that was approved, quoted, and potentially already in pre-production is now mismatched to the actual contents. The procurement team faces a choice: accept the dimensional mismatch and use filler material to compensate for the gaps (which undermines the premium positioning), or request a box revision that will push the delivery date past the gifting occasion (which defeats the purpose of the programme). Neither option is satisfactory, and both could have been avoided if the box type decision had been sequenced after the contents confirmation.

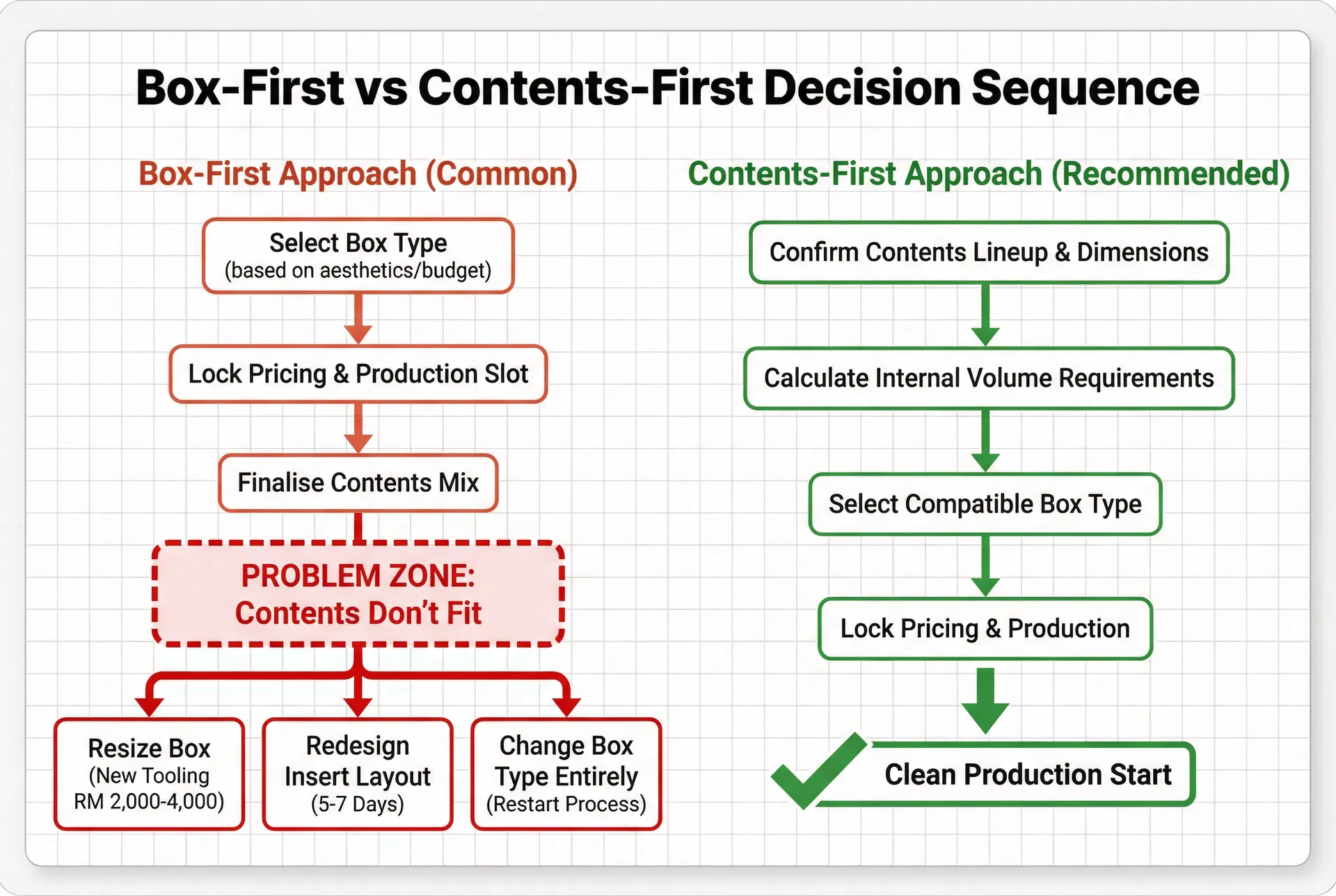

From the factory perspective, the most effective procurement teams we work with have adopted a two-stage approval process. In the first stage, they present the programme concept to internal approvers with a format range rather than a format selection—"the packaging will be a rigid box in the RM 18 to RM 30 per-unit range, with the specific format determined after contents confirmation." This gives approvers the budget visibility they need without locking the structural specification prematurely. In the second stage, once the contents lineup is confirmed with actual product dimensions and weights, the team selects the specific box type, commissions the structural sample, and proceeds to production with a specification that matches the actual contents. The two-stage approach adds approximately one week to the planning phase but eliminates an average of two to three weeks of rework during the production phase. The net timeline is shorter, the cost is lower, and the final product fits the contents precisely because the box was designed around the contents rather than the contents being forced into a pre-approved box.
The teams that continue to lock the box type first are not making an irrational decision. They are responding to an internal approval structure that rewards visual certainty over operational accuracy. The proposal with the rendered box image and the confirmed per-unit cost moves through approval faster than the proposal with a format range and a conditional cost estimate. But the speed gained in the approval phase is consistently lost—and then some—in the production phase, where every contents change triggers a rework cycle that the original timeline did not anticipate. The sequencing error is not a knowledge gap. It is a process design flaw that prioritises the approval experience over the production experience, and the cost of that prioritisation is absorbed invisibly across tooling revisions, insert redesigns, and timeline extensions that are reported as "supplier delays" rather than as consequences of premature specification lock.
For programmes with complex contents—multiple items from different suppliers, items with variable dimensions across production batches, or contents that include both rigid objects and flexible items like textiles or pouches—the sequencing discipline becomes even more critical. A gift box containing a ceramic mug, a packet of ground coffee, a branded notebook, and a pen set involves four items with four different dimensional tolerances, four different weight profiles, and four different fragility requirements. The insert must accommodate all four simultaneously, and the box must provide sufficient internal volume for the insert plus a clearance margin for assembly. Specifying the box type before all four items have confirmed production dimensions is not an approximation—it is a guess. And in our experience, that guess is wrong often enough that the resulting rework has become a predictable, recurring cost centre in corporate gift box production. The teams that have eliminated this cost centre did so not by choosing better box types, but by choosing them later in the process, after the contents gave them the dimensional certainty that accurate box specification requires.
Related Articles
Corporate Gift Box Types for Business Needs
A comprehensive guide to matching corporate gift box formats with different business occasions, recipient tiers, and procurement constraints in Malaysia.
The Scalability Inversion Trap
Why the gift box type that performs well at 200 units can become operationally unviable when the programme scales to 2,000 units.
